Beaconia Well Changes
The RM of St. Clements continues to address the issues surrounding the Beaconia Well, following recent regulatory updates and the issuance of a well sealing order. We want to ensure that our residents are fully informed about the status of this vital water system and the steps we are taking to comply with provincial regulations.
Overview
As part of our commitment to enhancing communication with residents by embracing innovative, information delivery methods. Below are AI generated videos of the information provided on this website.
Background
| September 2020 | The RM is advised that the Beaconia Pail Fill is not meeting regulatory compliance with the Groundwater & Well Water Act of Manitoba. The RM is directed to bring the free flowing artesian well under control by any means necessary in order to comply with the Groundwater and Water Well Act and associated regulations. |
| 2021 | Options were considered to gain compliance with regulations: 1. Decommission well and direct users to alternate location such as the Truck Fill opening Fall of 2022 at the East Selkirk Water Treatment Plant 2. Upgrade the well to allow flow control to satisfy regulations which requires significant upgrades to prevent freezing of the well. Options include Self Draining pipe similar to existing station, Modern Jug/Pail Fill station 3. Upgrade to Truck/Bulk Fill station and adopt a user pay system to cover significant capital investment and maintenance costs |

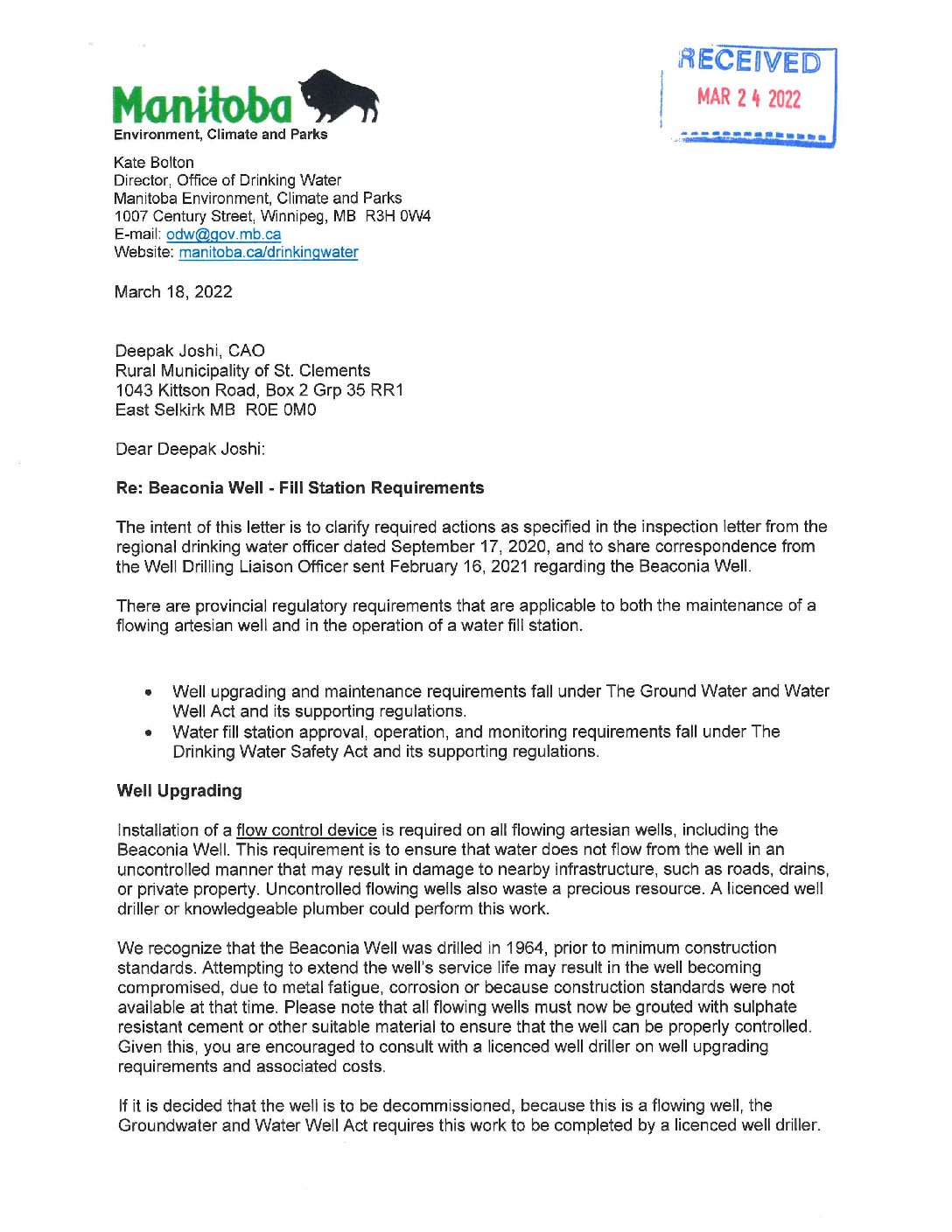

| Late 2021/Early 2022 | Public Works assessed costs of investment, maintenance and asset/financial risk for the various options. The recommendation was made to Council that the most economical and low risk option was to decommission the well and direct users to an alternate water source such as the new Truck Fill station opening at the East Selkirk Water Treatment Plant in Fall 2022. Council resolved that maintaining the public’s access to water free of charge at this specific location is preferred. In addition, Council directed administration to develop a communication plan to advise residents of this requirement to comply with the provincial act and regulations. |
| 2025 | The matter became more urgent when the Province issued a formal Well Sealing Order on February 18, 2025. The order required the existing Beaconia Well to be decommissioned by September 2, 2025. The RM continued to explore alternatives to outright loss of the service. On February 26, 2025, it requested that the Province permit the Beaconia facility to be converted to a non-potable water source, accompanied by flow control, signage, notices and regular testing. The Province subsequently advised that: – the September 2, 2025 deadline remained in place at that time; – conversion to a non-drinking-water fill station was not an acceptable regulatory solution; – a new compliant public water system could be developed; and – a newly constructed pail-fill system could potentially operate without continuous disinfection, subject to regulatory approval and a demonstrated history of satisfactory bacteriological water quality. At that point, the RM moved away from trying to keep the old well in service and focused on building a new, compliant artesian well and pail/jug-fill system at the Beaconia site. |
| 2026 | Work on the new compliant water system continued through the spring and summer of 2026. Where possible, the RM kept the existing well available during construction so residents would not lose access while the replacement system was being completed. On June 24–25, 2026, the Beaconia facility was temporarily closed to allow electrical service to be connected to the new well building. The work included trenching, electrical installation, backfilling and site restoration and represented another significant step toward commissioning the replacement facility. Current Status: On August 13, 2026, the new Beaconia Pail Fill Station was open, approved and available for residents to use. The new Beaconia Pail Fill Station is approved and available for public use; and the former well is permanently decommissioned as part of the transition to the new compliant system. This is a significant milestone. The RM has replaced an aging, non-compliant well with a new compliant public pail-fill system, while keeping local water access in Beaconia and meeting the Province’s decommissioning order. |
